The landscape at John S. Rainey Generating Station is changing day by day. From massive concrete foundations to towering cranes lifting heavy machinery, our landmark expansion project is moving full steam ahead. Santee Cooper is expanding the plant through a combined-cycle conversion to support South Carolina’s rapid growth while continuing to deliver reliable and highly efficient energy.
Here’s a look at the progress we’ve made on-site, the major equipment driving this expansion and the milestones coming next.

At its core, the combined-cycle conversion project is about optimizing what we already have. The team is converting two existing simple-cycle units into an integrated, highly efficient combined-cycle power plant. Simple-cycle generation uses natural gas turbines to produce electricity, while combined-cycle generation adds a steam-powered stage that uses heat from the turbine exhaust to generate more power. By recovering energy already present in the turbine exhaust, the conversion will add approximately 184 megawatts (MW) of generating capacity without requiring additional natural gas for that extra output.
This increases the station’s generating capacity and improves efficiency without increasing its overall emissions rate. It’s a significant step forward in meeting growing demand for reliable electricity while maintaining our commitment to environmental stewardship.
Beyond grid reliability, this three-year project drives local economic growth by bringing roughly 300 skilled construction jobs to the region during peak activity.

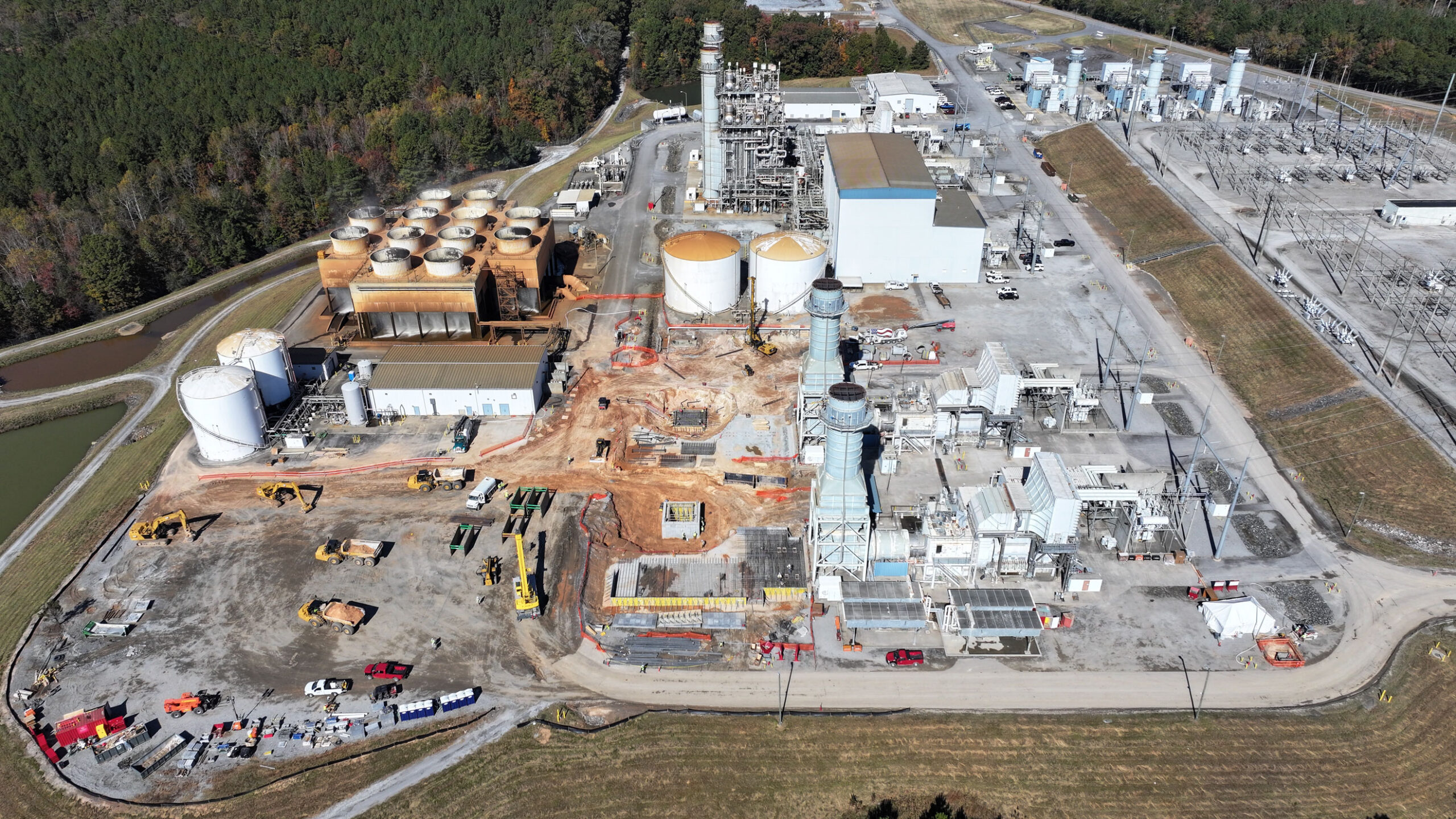

Before the massive steel structures could rise, the groundwork had to be flawless. Our journey started last year.

Nov. to Dec. 2025

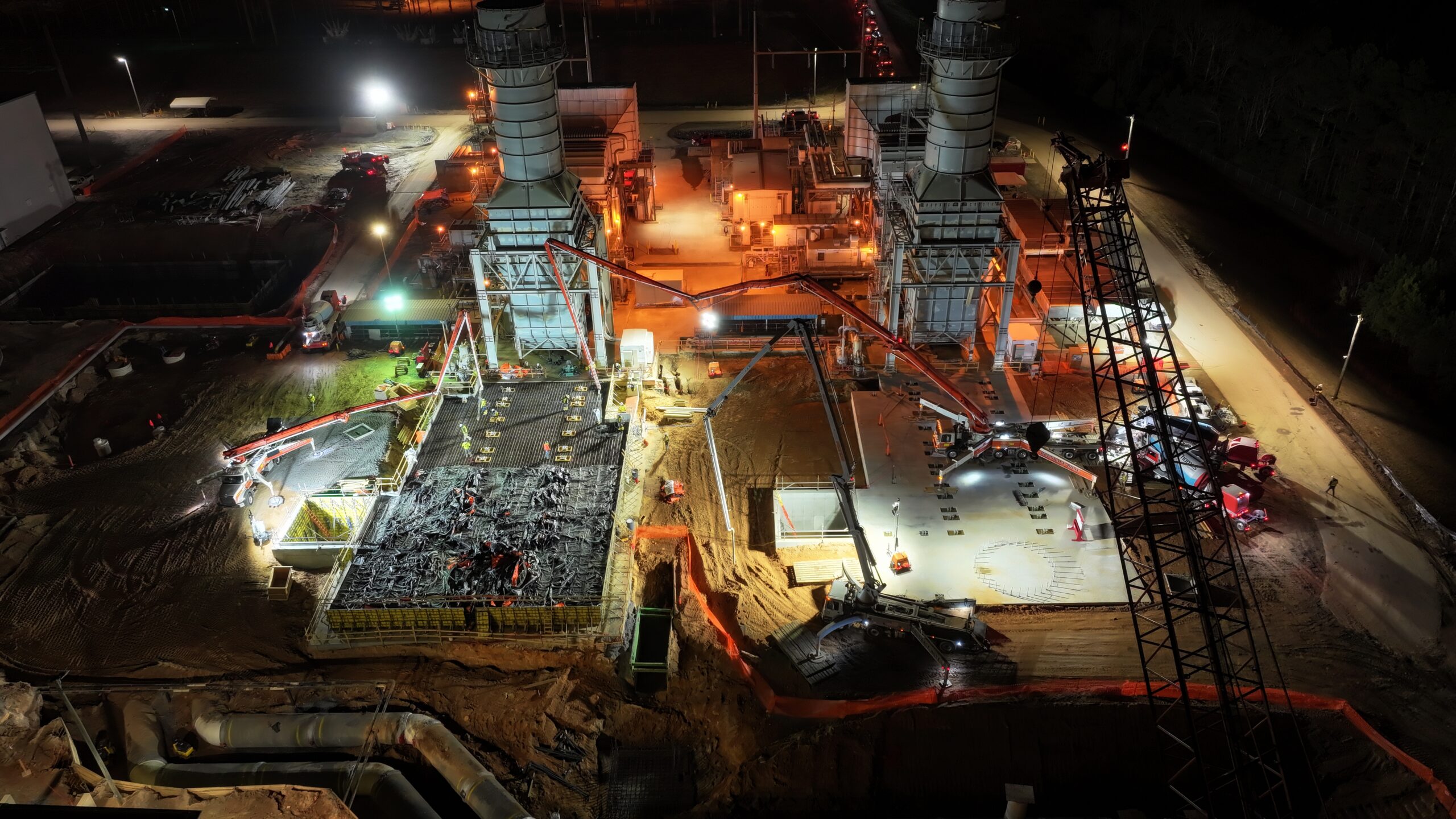

Massive Concrete Foundation Pours
Why It Matters:
Creates a heavy-duty base to support multi-ton equipment, such as the Heat Recovery Steam Generator (HRSG).

May 2026

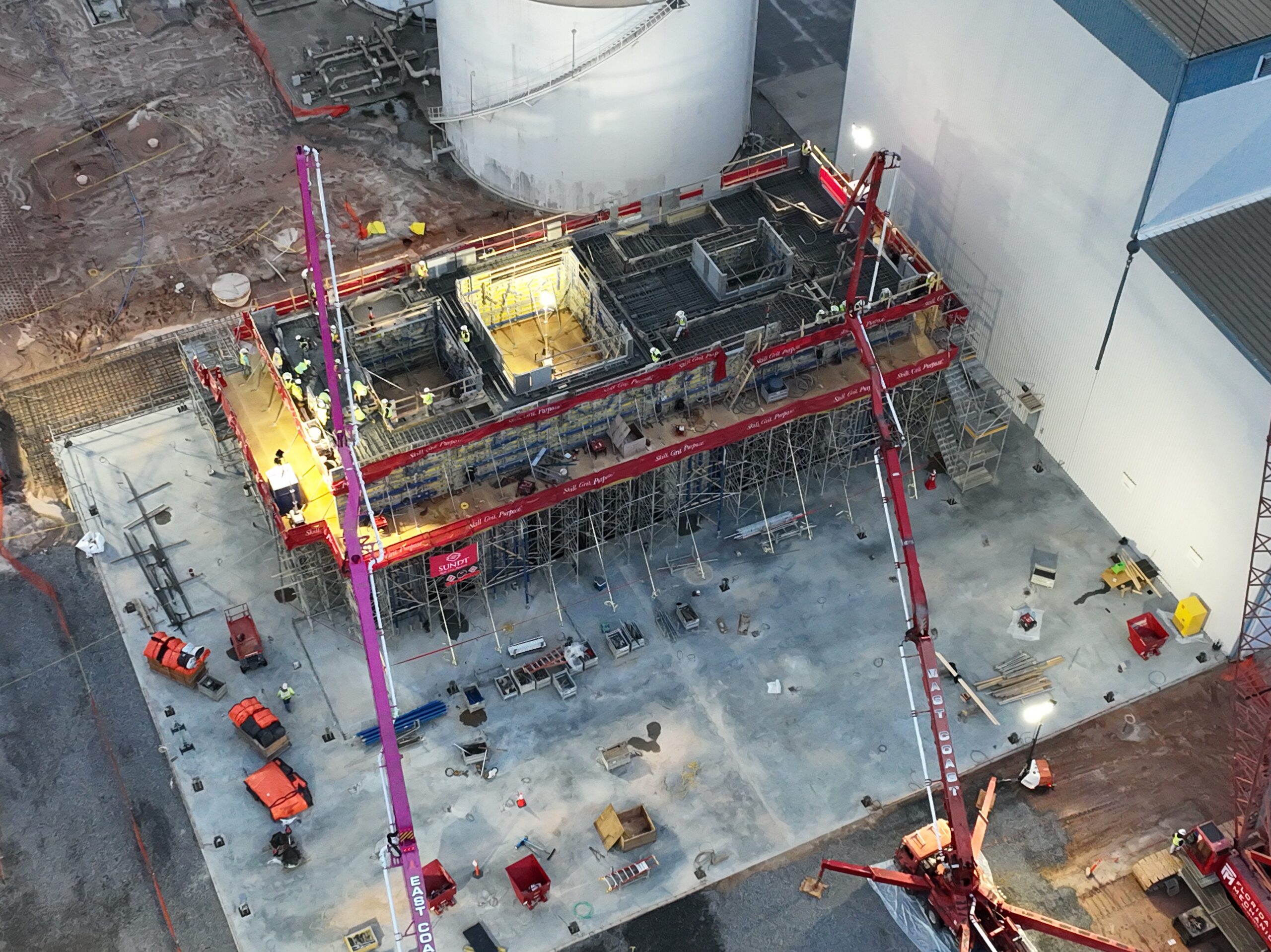

“Tabletop” Concrete Platform Pours
Why It Matters:
This specialized, ultra-stable platform is designed to safely support high-vibration machinery, such as generating units.

June 2026

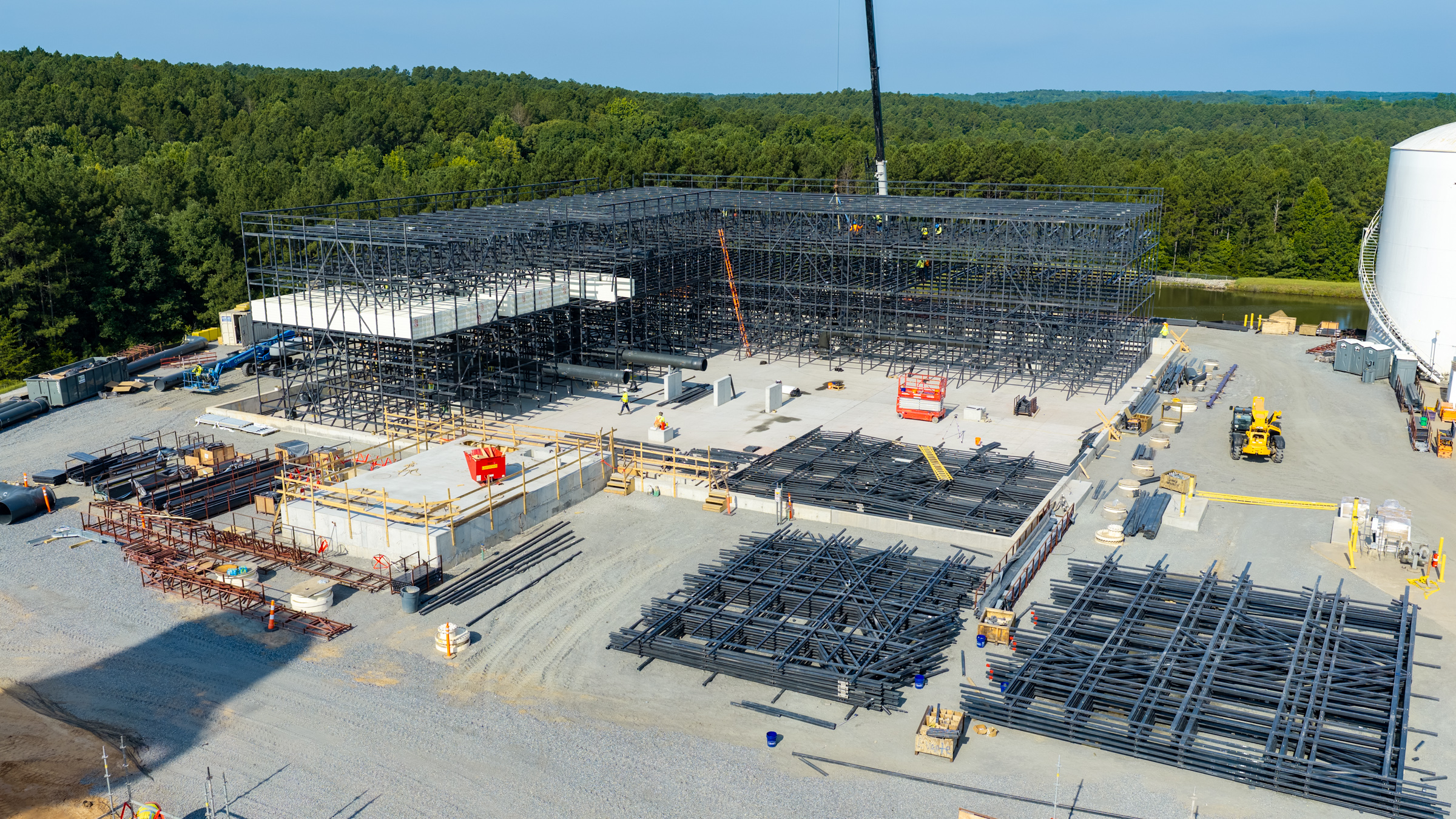

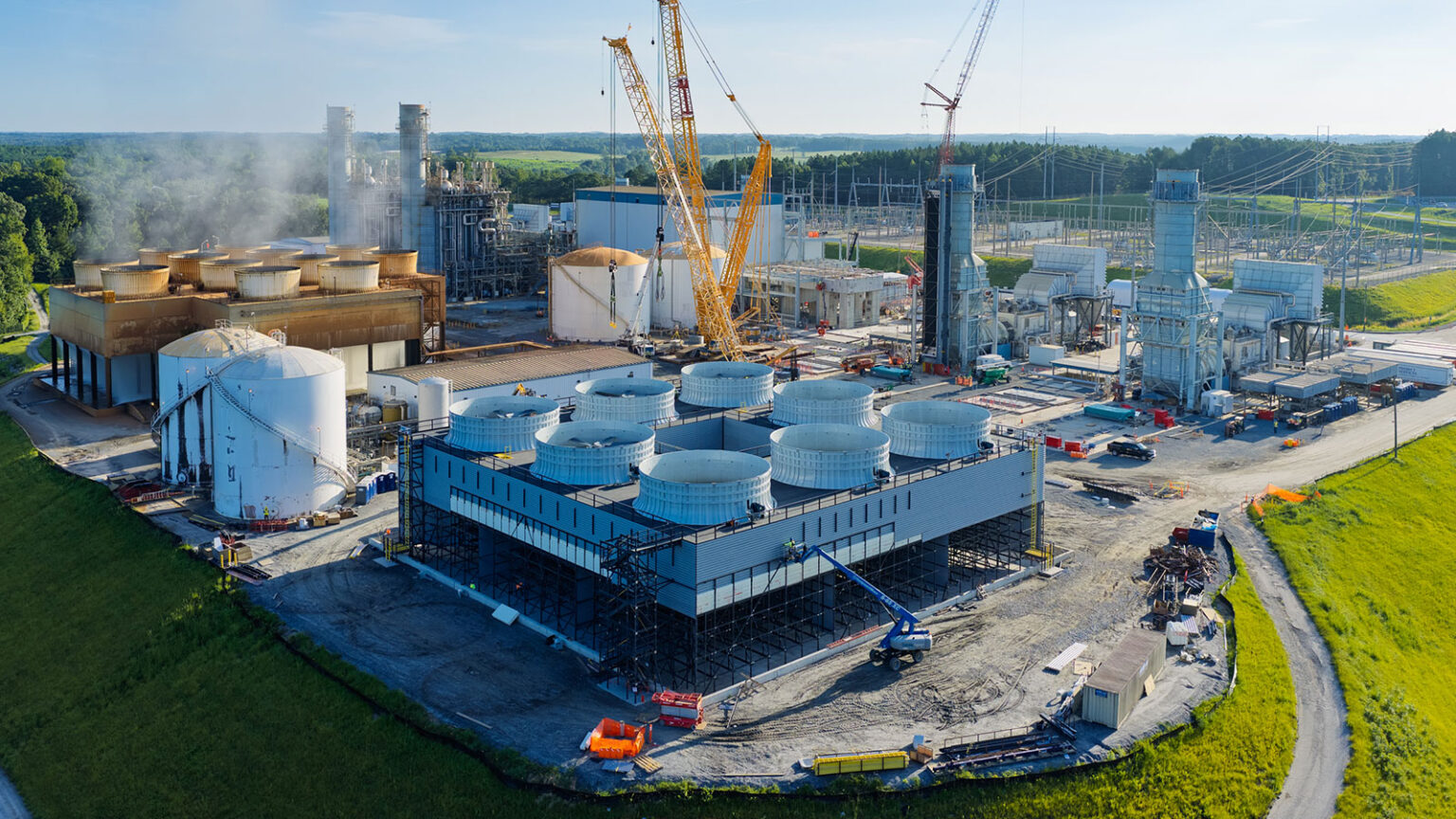

Cooling Tower Construction Begins
Why It Matters:
The new cooling tower is an essential component for managing heat during the power generation process.
With critical foundation work completed, the site was ready for two major components: the steam surface condenser and HRSG.
The steam surface condenser is a key component of the combined-cycle system, cooling exhaust steam from the steam turbine back into water so it can be reused.

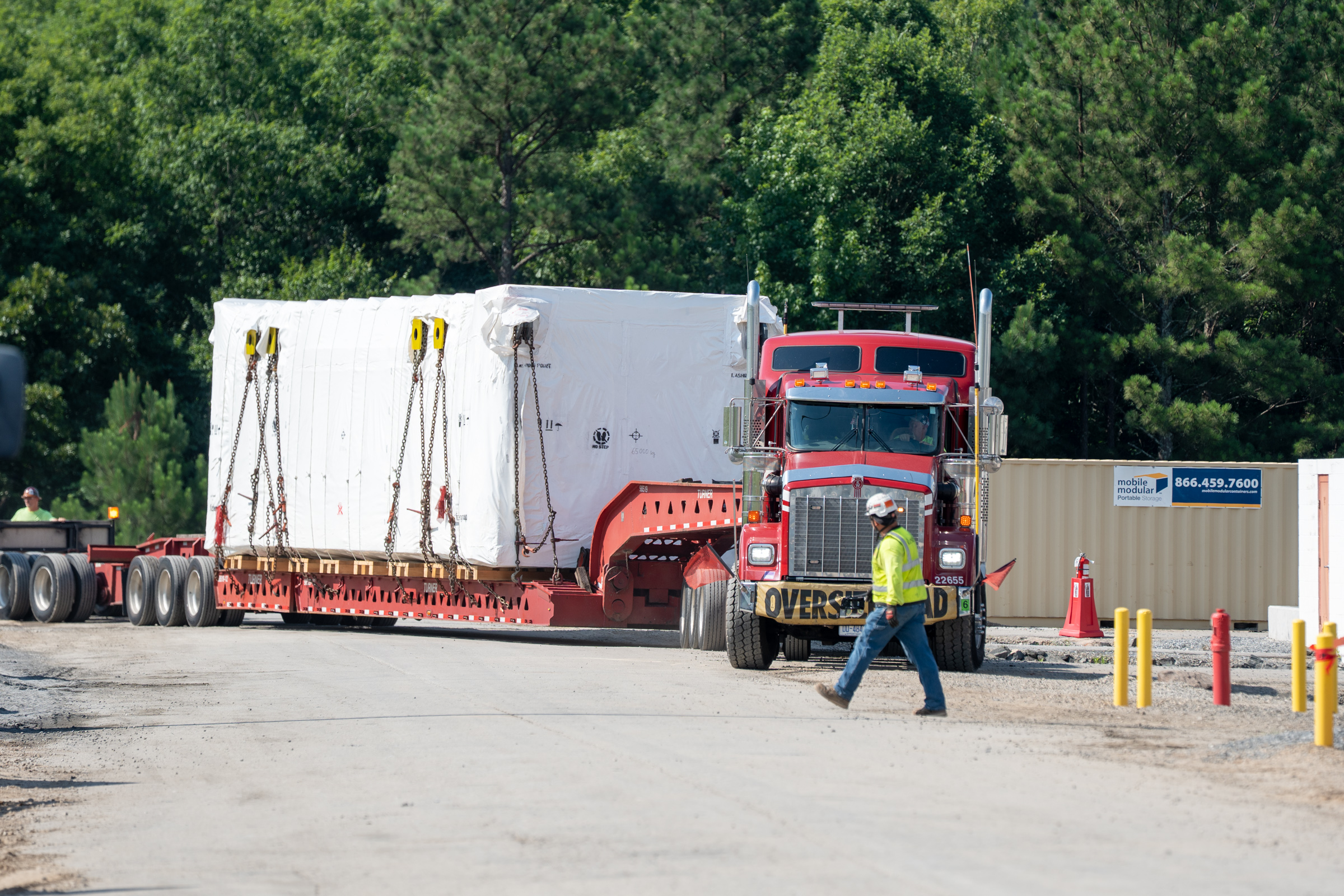

The project reached an exciting new phase in July with the arrival and construction of the station’s new condenser. By returning steam to water in a continuous closed loop, the system helps maximize efficiency and conserve water resources. A separate cooling-water system removes heat from the condenser without mixing with the steam.

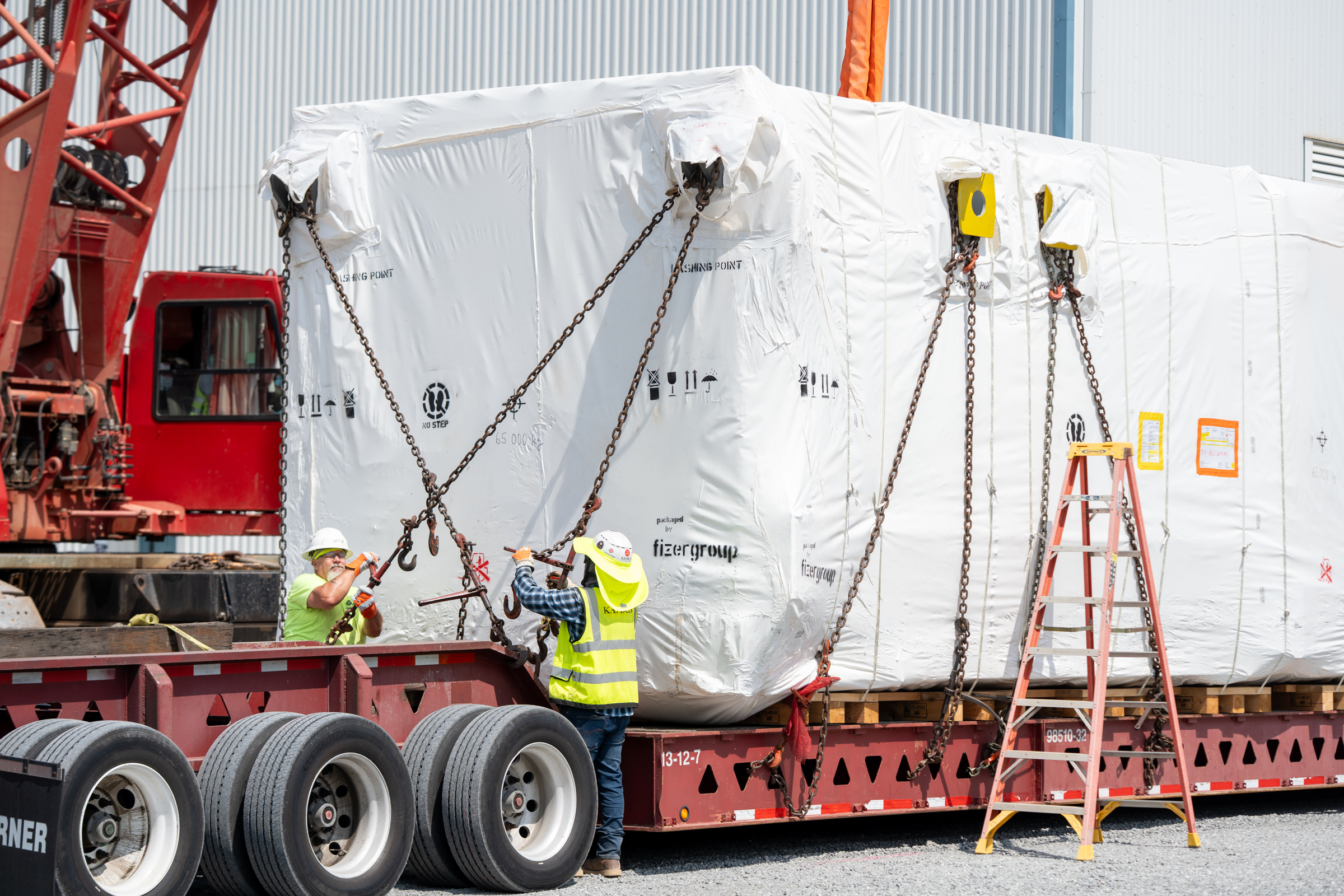

Delivering the massive condenser components to the site required months of planning. Once onsite, our rigging and construction crews precisely positioned, secured and assembled the unit.

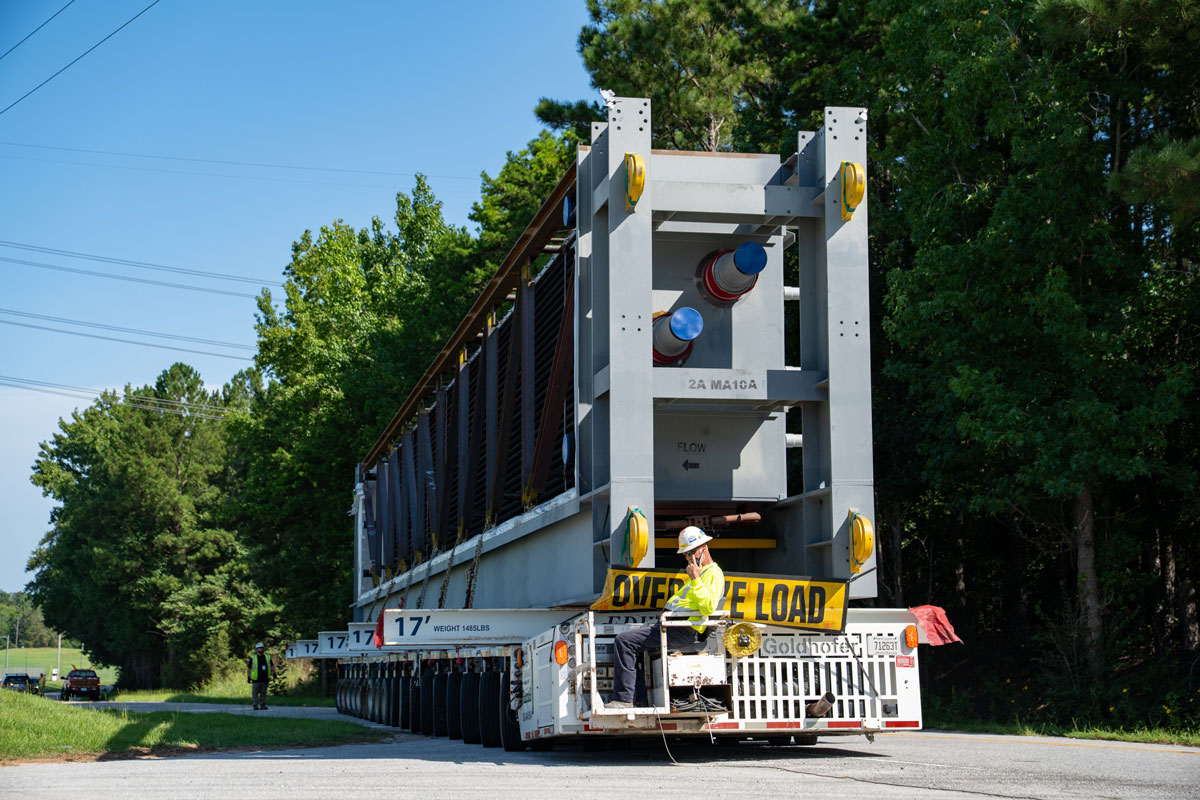

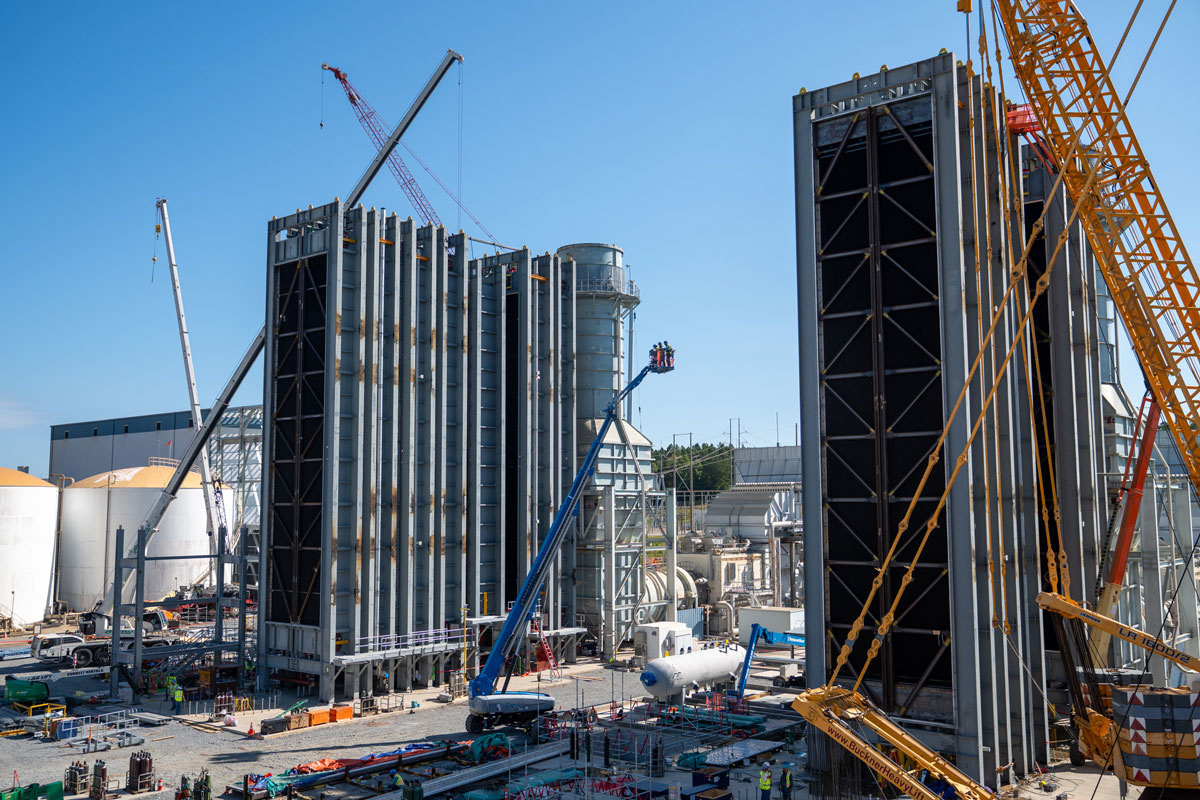

In a combined-cycle plant, the HRSG captures hot exhaust gas from the gas turbine and uses that heat to generate superheated steam for the steam turbine. Following our foundational concrete pours last winter, assembly of the HRSG marked a period of rapid progress onsite.

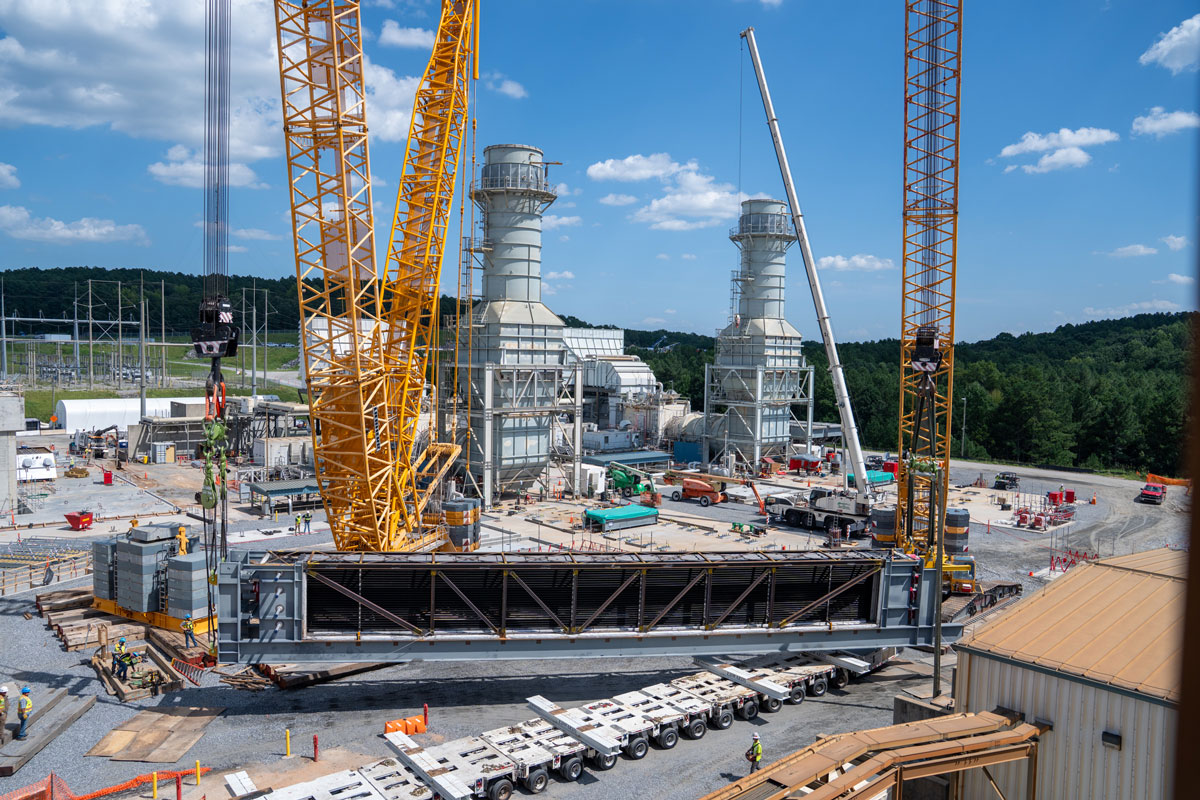

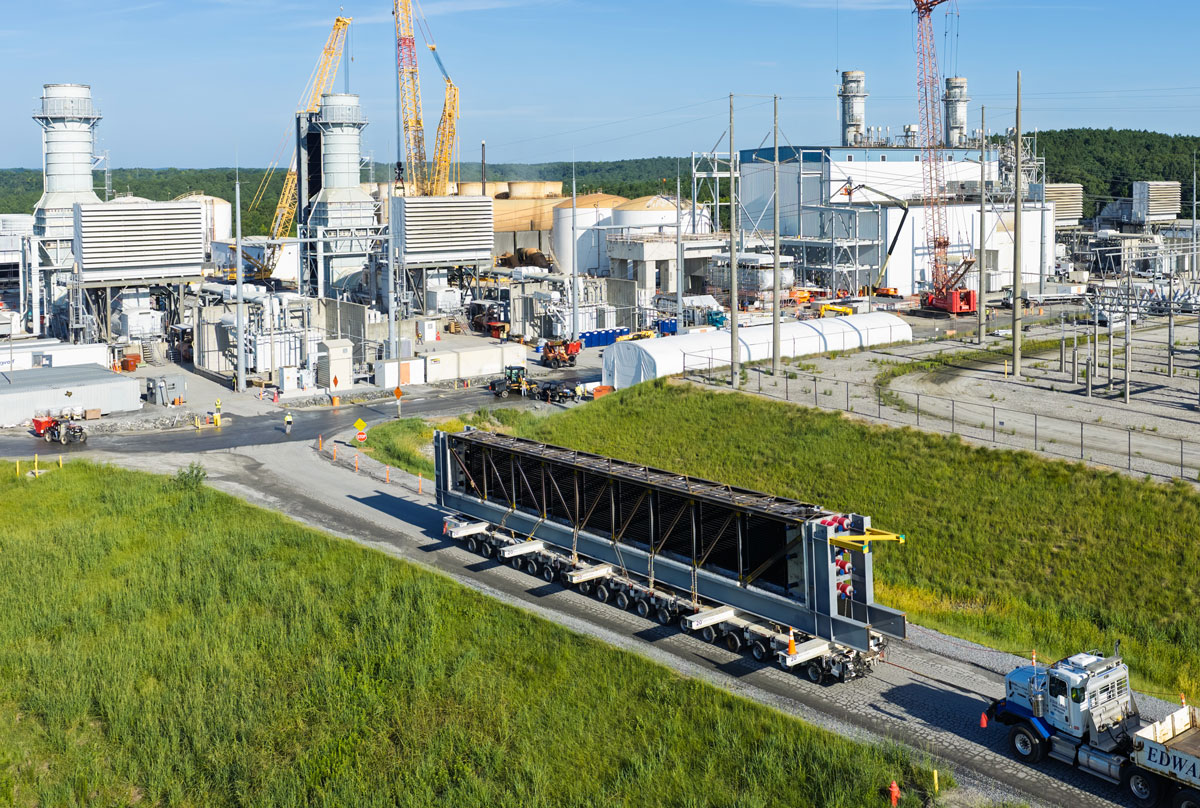

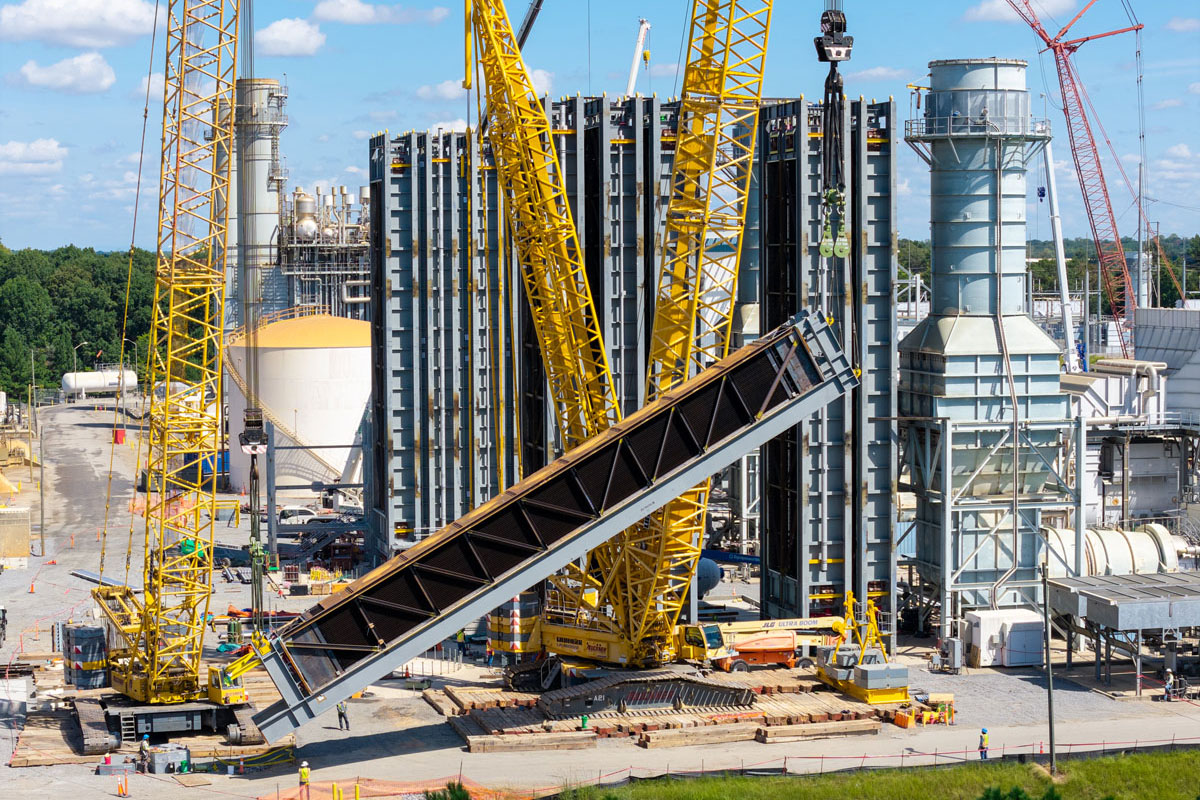

Crews worked through early September to complete the assembly of the towering HRSG structures, which stand over 100 feet tall. Later that month, the team successfully lifted and placed the massive steam drums into position atop the completed towers, finalizing the core of the new unit.
While we celebrate how far we’ve come, we’re already preparing for the next phase of expansion: the delivery of the steam turbine generator (STG).
Scheduled to arrive later this fall, the STG will use steam produced by the HRSG to generate electricity from recovered heat.
Given its immense weight and precise engineering, the arrival, offloading and installation of the STG will be one of the most technically demanding phases of the entire project. The team is already preparing the foundation and coordinating the complex transport logistics.
As each new piece of machinery locks into place, Santee Cooper moves one step closer to delivering an even stronger, more sustainable grid for the communities we serve. Milestones like these aren’t just dates on a calendar. They represent thousands of hours of planning, engineering, manual labor and an unwavering commitment to safety.
Even after a combined-cycle power plant recovers heat from gas turbine exhaust to generate additional electricity, some heat remains in the steam cycle and must be removed. The condenser cools exhaust steam from the steam turbine back into water so it can be reused. A separate cooling-water system carries away that heat, and the cooling tower releases it into the atmosphere.
The Rainey Generating Station expansion is a three-year project. Construction milestones have included foundation work, cooling tower construction, condenser installation and HRSG assembly. The steam turbine generator is scheduled for delivery in fall 2026, with additional installation work to follow. A specific completion date hasn’t been confirmed in the available project details.
